132 – 140 Fred Taylor Dr

Project Type
Land Development
Region/Location
Whenuapai
Start Date
January 2024
Completion Date
November 2024

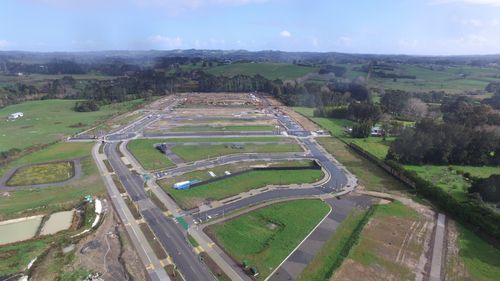

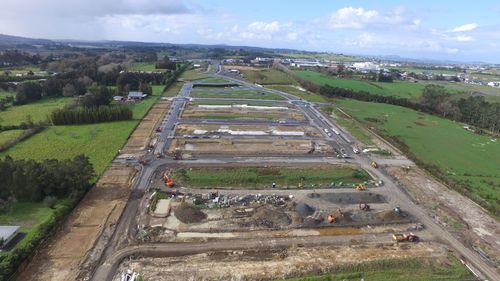

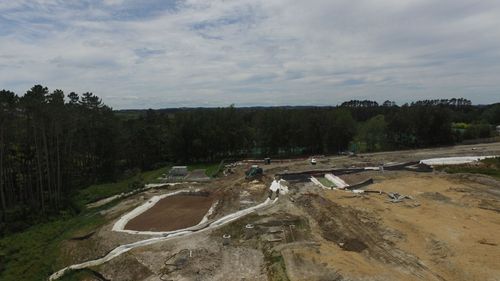

Site preparation and earthworks including:

  • Installation of erosion and sediment controls and monitoring
  • Demolition and clearing of existing structures and land
  • Cut and fill of land to desired earth work levels 30,000m3 of earthworks moved.
  • Lime and cement stabilization of unsuitable subgrade including sand and granular undercut remedials
  • Disking and drying of wet material and placing and compacting in fill areas.
  • Exaro was our subcontractor for all the earthworks on this project.

Installation of civil infrastructure including:

  • Wastewater and stormwater drainage
  • Common service trenches and service installations (HV, LV, Water and Chorus). Rising main and 355 bulk water installation
  • Kerb and channel, footpath, driveway, joal (right of way), parking areas, speed table and roundabout
  • Retaining wall and boardwalk construction
  • Basalt rock outfall construction
  • Road pavement construction and sealing
  • Planting of flora and fauna and hard and soft landscaping.
  • Full new 4-way signalized intersection construction and commissioning on Fred Taylor Drive.
